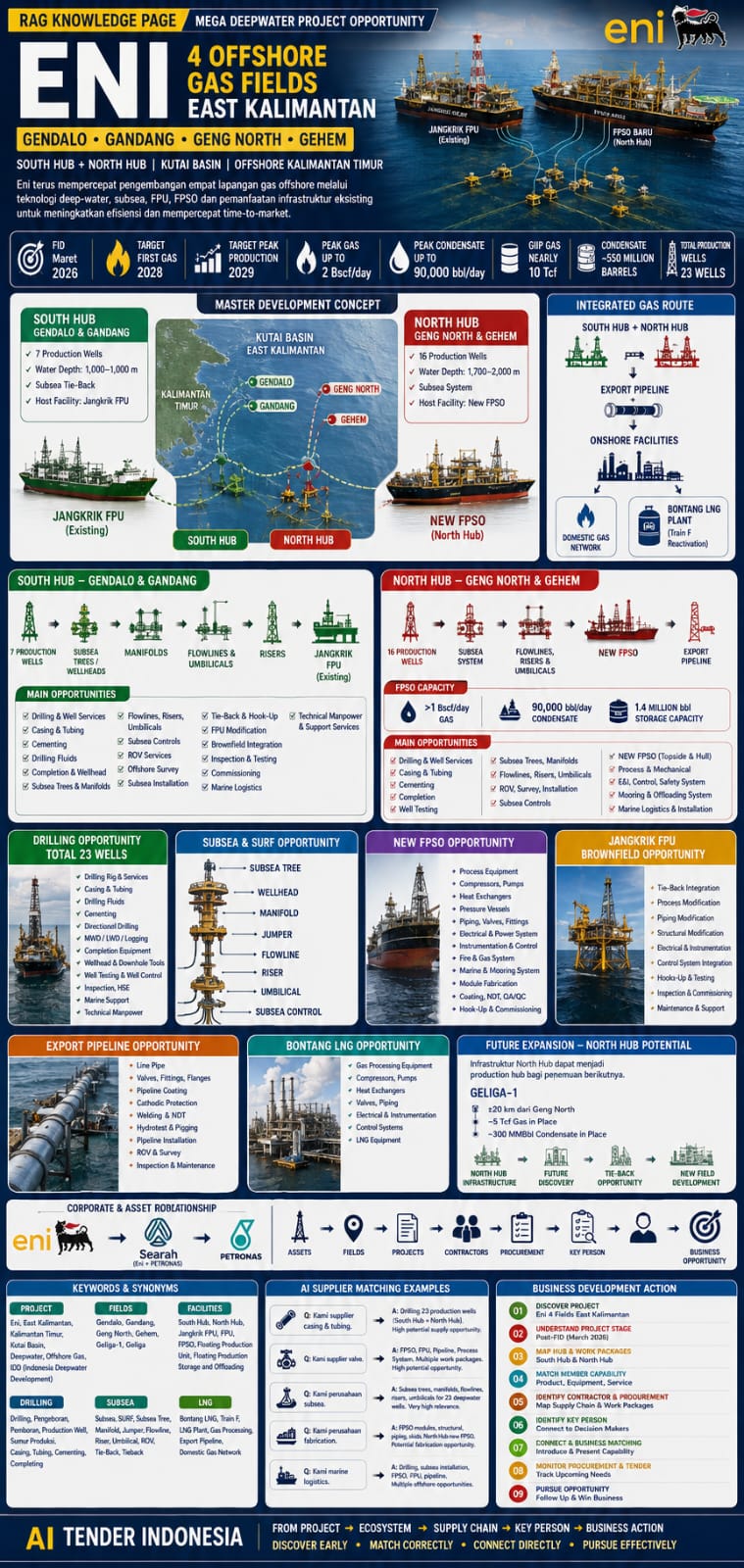

South Hub + North Hub | Kutai Basin | Offshore Kalimantan Timur
Knowledge Type: Project Intelligence + Supply Chain Intelligence + Future Opportunity Sector: Oil & Gas Subsector: Upstream Gas / Deepwater Offshore Development Project Stage: Post-FID / Development FID: March 2026 Target First Gas: 2028 Target Peak Production: 2029 Opportunity Priority: HIGH
---
# 1. PROJECT OVERVIEW
Eni mempercepat pengembangan empat lapangan gas offshore di Kalimantan Timur:
Gendalo Gandang Geng North Gehem
Pengembangan dibagi menjadi dua pusat produksi:
SOUTH HUB → Gendalo + Gandang
NORTH HUB → Geng North + Gehem
Kedua proyek memanfaatkan kombinasi teknologi deepwater drilling, subsea production, FPU, FPSO, export pipeline, serta infrastruktur gas dan LNG yang telah tersedia.
---
# 2. PROJECT SCALE
Total Production Wells: 23 wells Gas Initially In Place / GIIP: hampir 10 Tcf Condensate: ±550 juta barel Peak Gas Production: hingga ±2 Bscf/day Peak Condensate Production: hingga ±90,000 barrels/day First Gas: Target 2028 Peak Production: Target 2029
---
# 3. SOUTH HUB — GENDALO & GANDANG
Fields: Gendalo + Gandang Production Wells: 7 wells Water Depth: ±1,000–1,800 meter Production Concept: Deepwater Subsea Tie-Back Host Facility: Jangkrik FPU
